Mission-critical market

Data Centers in the Phoenix Market

This market runs on megawatts that have to be delivered before anything gets built. Here is what that means for the electrical package.

Phoenix is a top-tier US data center market. The number that matters to an electrical contractor is not square footage; it is megawatts, and where they can actually be delivered. CBRE's last published per-market inventory figure put Phoenix at 602.8 MW at year-end 2024, fourth among the eight primary North American markets. Read this page as capability — we do not list projects we have not built.

The market, in the numbers that are published

That 602.8 MW is a year-end 2024 count and the most recent per-market figure CBRE has published for Phoenix. One 2026 source has Chicago passing Phoenix into fourth, which we cannot verify against CBRE — so treat any current ranking as unconfirmed.

CBRE put the eight primary North American markets at 10,903 MW in the first half of 2026, up 33.7 percent year on year, on a record-low 1.4 percent vacancy. Locally, four colocation projects absorbed 256 MW in the second half of 2025, with completions expected within twelve months across Mesa, Phoenix, Avondale, Goodyear and Glendale.

Where the load is going

  • Mesa and the Elliot Road corridor. East Valley industrial growth is data-center led; NTT Data, EdgeCore, Google and Meta all have publicly reported campuses.
  • Loop 303 — Goodyear, Avondale, Buckeye. Compass in Goodyear, Stack in Avondale, and Tract's Buckeye Technology Park, approved August 2024 and reported at 2,069 acres and roughly 1.8 GW at full build.
  • North Phoenix and Deer Valley. Aligned is reported to have broken ground on an 80 MW campus in Q4 2025.
  • El Mirage. Microsoft is reported to hold about 150 acres there, part of roughly 576 acres across three West Valley sites.

Those campuses are market geography, from public reporting — not clients. Every project statement on this site is capability, not portfolio.

Powered land is the constraint, not demand

CBRE's Phoenix read says it plainly: APS and SRP power-delivery restrictions are limiting the availability of powered land, and SRP was processing its first cluster study of 25 applicants with mixed initial results. The utility conversation does not follow design. It decides whether there is a project.

Which utility serves a site is not readable from the city name. SRP describes its own cities as served all or in part, and APS serves portions of Phoenix, Glendale, Peoria, Avondale and Scottsdale. Downtown Mesa is a third answer: the city runs its own municipal electric utility. The address decides the standards manual and the cost rules.

  • APS extensions run under ACC tariff Service Schedule 3 — a line extension agreement, all project costs paid in advance, no interest on advances, and anything unrefunded at five years becoming a non-refundable contribution in aid of construction.
  • Redundant capacity is priced as such. Schedule 3 section 9.4 lets APS add a capacity-factor component for applicants requesting excess or redundant capacity. A 2N request is not two N services at the same unit rate.
  • SRP is not rate-regulated by the Corporation Commission, so none of that applies. Its contributions in aid of construction are generally non-refundable, and any extension over 1,000 feet is individually evaluated and agreed in writing.
Pad-mounted transformer set on a finished concrete pad
The trench, the conduit and the pad are ours. What sits on top of the pad is not.

What the electrical scope actually is

Above the floor the work is unremarkable in kind and unusual in quantity. The money is in three places: the service and medium-voltage distribution, the standby plant, and the underground tying them together.

  • Service entrance and medium voltage. SRP caps a new three-phase four-wire underground service entrance section at 3,000 A, at 277/480 V and 120/208 V alike. Above that: multiple sections, totalized metering at SRP's discretion, or primary-metered service under APS ESRM Section 1000.
  • UPS and critical distribution. Input and output switchboards, maintenance bypass and interlocks, battery room feeders and disconnects, PDUs, static transfer switches, remote power panels, busway or whips, and the control and alarm wiring nobody prices.
  • Standby plant and underground. Paralleling switchgear, the generator yard, fuel system power and controls, load bank connections, the transfer scheme, and concrete-encased duct bank from the point of delivery to the building.
  • Branch-circuit metering. Phoenix deleted IECC C405.13, energy monitoring, in its entirety along with C405.12 and C405.15. Here it is an owner requirement, not a code one — specify it or it is not in the bid.

Constraints particular to this sector, in this county

The gear submittal sits in front of the manufacturing release

APS ESRM 302.9 requires every commercial meter enclosure to be reviewed and approved by APS before the equipment is manufactured — one-lines, EUSERC page references, ampacity, bus bracing. Every APS commercial service above 200 A needs a EUSERC-approved CT-rated enclosure, and a separate application is required whenever the equipment has any provision for an inverter or generator, which here is always. SRP's review goes to shopdraw@srpnet.com, where Section 1 says over 225 A and Section 9 says 400 A. We submit at 225 A.

The standby plant crosses interconnection thresholds

APS follows ACC Article 26: Level 2 fast track below 2 MW, Level 3 study track at 2 MW and above. SRP is not bound by those rules and uses its own classes — Class III is 1 MW to under 3 MW, Class IV is 3 MW and up — applying all screens plus a detailed review at 1 MW and above, and no technical studies below it. Classification is the sum of every generator on site, which on a standby plant adds up fast.

SRP ended customer-owned service

SRP's Electric Service Specifications, Section 3, Note 6: no Customer-Owned Service after 6 July 2026. Existing customer-owned conductors may still be retained for maintenance and like-for-like replacement, but on a new build plan on SRP-supplied conductors.

Heat, dust and the local amendments

  • Phoenix's ASHRAE cooling design dry bulb runs around 110°F, and the informational note under NEC 310.15(B) names ASHRAE as the source. Through Table 310.15(B)(1), a 90°C conductor keeps 87 percent of its ampacity at 41–45°C and 82 percent at 46–50°C.
  • Where a raceway sits in direct sun less than 7/8 inch above a roof, 310.15(B)(2) adds 33°C before correction. XHHW-2 is exempt — a money lever on long sun-exposed runs.
  • NEMA 3R is rainproof and carries no windblown-dust requirement. Type 4 and 4X do. Generator yards and outdoor gear sit through haboob season.
  • EMT alone is not an equipment grounding conductor in Phoenix, Glendale or unincorporated Maricopa County — all three amend NEC 250.118(4) to require a wire-type EGC as well. Across a data hall that is a quantity.
Adopted electrical code and permit portal by submarket, from each jurisdiction's own published code list, September 2026. Arizona has no statewide building code — every municipality adopts and amends independently.
SubmarketAHJAdopted NECPermit portal
North Phoenix / Deer ValleyCity of Phoenix2023 NEC, effective 1 Aug 2025 (Ord. G-7397)SHAPE PHX
MesaCity of Mesa2023 NEC, effective 8 Jan 2026DIMES (Accela)
GoodyearCity of Goodyear2023 NEC, effective 23 Jun 2026Accela Citizen Access
BuckeyeCity of Buckeye2023 NEC, effective 1 Jan 2025 — but the 2018 IECCEnerGov Self Service (access code required)
AvondaleCity of Avondale2023 NEC, effective 1 Jan 2026Electronic plan review
GlendaleCity of Glendale2023 NEC, effective 9 Jan 2026City permit counter
El MirageCity of El MirageNot in our verified set — confirm with the building department before designConfirm with the city
County landMaricopa County P&D2017 NEC; energy code voluntaryPermit Center (Tyler EnerGov)

Buckeye is the trap in that table: the 2023 NEC since 1 January 2025, but still the 2018 International Energy Conservation Code. And in Phoenix's July 2026 report, minor commercial plan review averaged 33 days against a 25-day goal while major averaged 30 against 45.

How we deliver it

Utility first, gear second, everything else after.

  1. Confirm the serving utility at the address — an existing bill, the APS Phoenix Metro territory map, an SRP facility map request, or a phone call. Not the ZIP code.
  2. Load and topology to the utility early. APS ESRM 200.1 asks for eight items at application, including estimated loads with voltage and phase, building area and the meter location.
  3. Gear submittal into utility review before release for manufacture, with the generator and inverter application alongside it.
  4. Trench, conduit and pad to the utility's design, inspected before backfill. SRP wants 12 feet of clear working space at the front of a pad-mount and CLSM backfill per MAG Section 728.
  5. Studies on final gear data, not catalog data — short circuit, coordination and arc flash. See power studies.
  6. AHJ clearance, then energization. Only utility employees energize, and SRP will not energize the load side until the AHJ approves the installation.

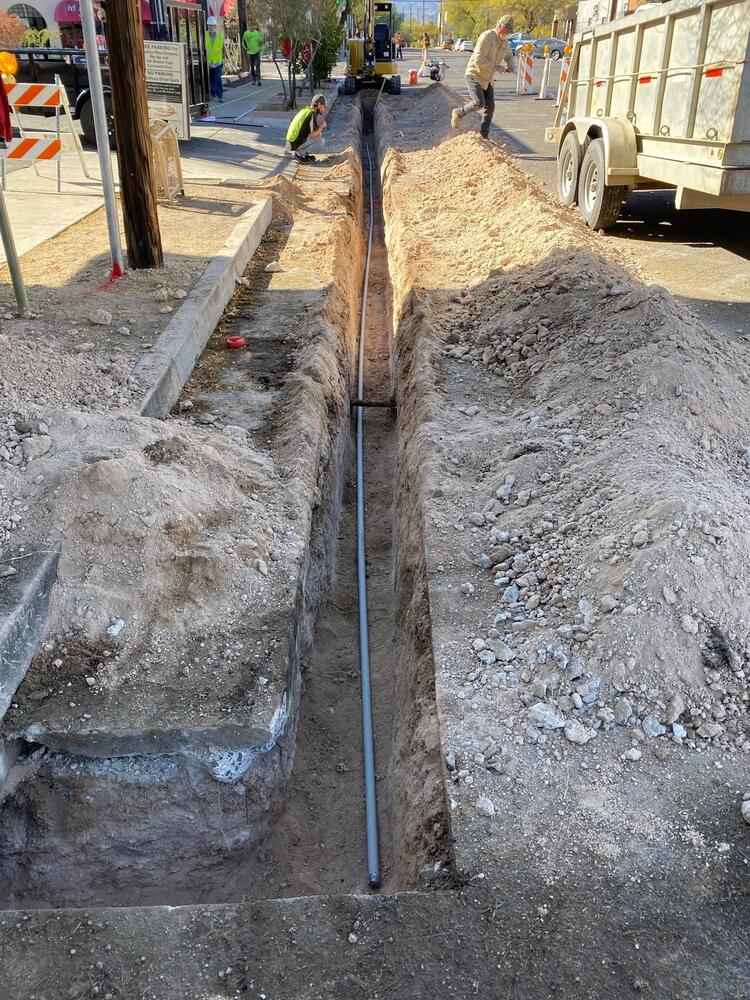

Conduit laid and racked in an open trench before backfill
Trench and conduit are inspected before backfill. Booking that inspection late is the cheapest way to lose a week.

Where we are the wrong call

  • We are not an EPC for a greenfield hyperscale campus. On a multi-hundred-megawatt build running a hyperscaler's program schedule, you will hear that on the phone, not after the bid opening.
  • Structured cabling and low voltage are not ours. The fiber plant, the DCIM network and the security system ride with a specialty contractor. We install the pathway, boxes, grounding and power.
  • Factory startup of UPS modules and generator sets is the manufacturer's. We land the feeders, set the interlocks and stand there for it.
  • No round-the-clock critical-facility desk. Posted hours are Monday to Thursday, 6:00 AM to 3:00 PM, and Friday, 6:00 AM to 2:00 PM. Outage work is scheduled and priced up front.

Where we do fit: service and distribution equipment, duct banks, the generator yard, gear setting and termination, the studies, and fit-out inside a running building. Scope detail is on the data center electrical page. Send the one-line and the utility correspondence. Get in touch.

Frequently asked questions

How big is the Phoenix data center market?

CBRE's last published per-market inventory figure put Phoenix at 602.8 MW at the end of 2024, fourth among the eight primary North American data center markets. That is a 2024 number and it is the most recent one CBRE has released per market, so treat it as a floor rather than a current total. One 2026 report indicates Chicago has since passed Phoenix into fourth place, which we have not been able to verify against CBRE directly, so we would not state a 2026 ranking as fact. On activity rather than inventory, CBRE recorded four Phoenix colocation projects absorbing 256 megawatts in the second half of 2025, with full-scale completions expected within twelve months across Mesa, Phoenix, Avondale, Goodyear and Glendale.

Why is powered land the bottleneck here rather than demand?

Because the utilities are rationing delivery. CBRE reports that APS and SRP power-delivery restrictions are limiting the availability of powered land sites in Phoenix, and that SRP was working through its first cluster study of 25 applicants with mixed initial results. The cost rules are front-loaded at both utilities as well. Under APS tariff Service Schedule 3 the applicant signs a line extension agreement and pays all project costs in advance, refundable advances earn no interest, and anything unrefunded after five years becomes a non-refundable contribution in aid of construction. SRP is not rate-regulated by the Corporation Commission and its contributions in aid of construction are generally non-refundable, with any extension over a thousand feet individually evaluated and agreed in writing. Neither utility publishes a committed timeline for commercial new service, and we will not invent one.

Have you built a data center in Phoenix?

This page is written as capability, not as a portfolio, and we are not going to list projects we have not built. The owner's standing rule is also that customer names and site addresses stay off our public pages, on every sector. What we can describe precisely is the work itself: service entrance and medium-voltage distribution, UPS input and output switchboards with their maintenance bypass and interlocks, PDUs and static transfer switches, remote power panels and branch distribution, the standby generator plant with its paralleling and transfer scheme, concrete-encased duct bank, grounding, and the testing and documentation a commissioning agent will ask for. If you want to know whether we are the right fit for a specific package, send the one-line and the utility correspondence and we will tell you which parts we should be bidding and which parts belong to someone else.

What edition of the NEC applies in the data center submarkets?

It depends on which side of a property line the site sits, because Arizona has no statewide building or electrical code. Cities and counties adopt and amend independently under A.R.S. Title 9 and A.R.S. 11-861, which is why two projects a mile apart can be designed to different code cycles. Phoenix has enforced the 2023 NEC since 1 August 2025 under Ordinance G-7397. Buckeye moved to the 2023 NEC on 1 January 2025 but kept the 2018 International Energy Conservation Code. Avondale followed on 1 January 2026, Mesa on 8 January 2026, Glendale on 9 January 2026, and Goodyear on 23 June 2026. Unincorporated Maricopa County is still on the 2017 NEC and its energy code is voluntary rather than mandatory. For any jurisdiction we have not verified from a primary source, El Mirage included, we call that city's building department before design rather than guess, because publishing a wrong code edition is the error an electrician catches fastest.

At what size does a standby generator plant trigger a utility study?

It depends entirely on which utility serves the site, and the thresholds are different. APS follows the Arizona Corporation Commission's Article 26 tracks, with the Level 2 fast track for facilities below 2 megawatts and the Level 3 study track at 2 megawatts and above, where the system impact study typically covers load flow, short circuit, circuit protection and coordination, and impact on system operation. SRP is not bound by those rules at all. It classifies distributed energy resources into four classes, with Class III running from 1 megawatt to under 3 megawatts and Class IV at 3 megawatts and above, and it applies all screens plus a detailed review at 1 megawatt and up that may include feasibility, system impact and facility studies. SRP states it does not currently require technical studies or system modeling below 1 megawatt. Classification is the sum of every generator connected at the site, so a bank of standby sets is added together. APS also requires ten business days of notice before commissioning tests or before a generating facility begins interconnected operation.

What do you need from us to give a real number on a data center package?

Six things, and the first two matter more than the rest. One, the serving utility confirmed at the address and any capacity correspondence you already have, because that decides the standards manual, the submittal path and the cost rules. Two, the one-line with the redundancy topology stated, and whether the kilowatts per cabinet figure is an average or a peak. Three, the gear specification, including whether the owner has a named manufacturer, since utility review of the meter enclosure sits in front of the manufacturing release and a topology change after that point restarts a queue nobody controls. Four, the commissioning specification, because integrated systems testing is labor we price rather than absorb. Five, the site civil, for duct bank routing and the transformer pad location. Six, the jurisdiction. Without the utility answer, any number is a guess dressed up as an estimate, and we would rather say so than send one.

Get a price on this scope

Phoenix, Mesa, Scottsdale, Chandler…

Ready to price your Phoenix project?

Send us the plans, the scope, or just the problem. We will tell you what it takes. Call (602) 396-5216 or request a bid online.

Request a Bid (602) 396-5216
